The end of Pen-Y-Mount Station in August 2000, this has been the end of the Welsh Highland since the new line opened in 1980. | Aug00 | Aug00 |
Looking back at P-Y-M Station, much of the undergrowth has been cleared between the crossing and the station building. This area will eventually be the start of the 'Harbour Branch', linking the Welsh Highland to the Ffestiniog. | Feb01 |
With Access to the extension restricted during the Foot and Mouth crisis, the area has been cleared for footpath demarcation. | Apr01 | Apr01 |
| |
|
In the Snow | | Dec00 |
|
Work restarts, this skip is full of scrap removed from the Penmount Farm section. | 1st Skip full | Aug012nd Skip full. |
Against a dramatic sky, a few of the team look back on the day's work. | Aug01 |
Christmas 2001, and a concrete mixing works train sits at the head of steel. | Dec01 |
|
The Knotweed area. This area has been cleared of rail, and overgrowth, to provide an area to dump Japanese Knotweed infected topsoil. The Topsoil will remain here until all the Knotweed has been removed. 2 Panels of the 'RED' siding have been removed to give access to the area. | Apr02 | Apr02 |
Mar02 | Mar02 |
Pen-y-Mount Station platform, having its new 'heritage' fence erected. | Mar02 |
| Mar02 | Mar02 |
North of Pen-Y-Mount Station, the footpath is fenced off to protect walkers from what will become the extension depot. This fence will be temporary, and currently runs along the line of the connecting line to the FR. | Mar02 |
| Mar02 | Mar02 |
|
During Civils week 2002 The Northern end of Pen-y-Mount Station was remodelled, to include a new crossover, and headshunt. However to prepare for this, the existing track has to be removed, and the area lowered to accommodate the new crossing over Penmount Lane Crossing. | June02 |
June02 |
June02 | June02 |
|
Civils Week, and the existing trackbed is dug up to allow a base of slate waste, and ballast to be laid. The new line is lower that the existing one, so the level crossing can be built. | Jul02 |
Jul02 | Jul02 | Jul02 |
Finally the 2 points are installed, 1 60lb from the FR, and one 75lb, and assembled on site. | Jul02 |
Aug02 | Aug02 | Aug02 |
Aug02 | Sep02 | Nov02 |
|
Pen-y-Mount Station is slowly being rebuilt. In September the new platform fence is installed. This has been built using original fencing materials found alongside the Croesor Tramway section of the Railway | Sep02 |
| Sep02 | Nov02 |
|
February 2003, and The station is being transformed into a construction site. | Feb03 | Feb03 |
|
November 03, and almost the last load of slate waste is being taken out of Pen-Y-Mount |
Nov03
|
Nov03
|
|
Feb 2004, the junction pointwork is uncovered. |
Feb04
|
Feb04 Feb04
|
|
31st May 04 The PYM headshunt is extended to form a new loading ramp, required for Lilla's visit in a few weeks time. |
May04
|
May04
|
|
May04
|
May04
|
|
26th June 2004 the 60lb point is re-gauged, and 40ft of rail connected to give access to the Harbour Siding.When the rails arrive, they will be unloaded each side of this siding, and rolled into the center to be moved to site. |
Jun04
|
Jun04
|
Jun04
|
Jun04
|
|
Rails Arrive at Pen-Y_Mount |
Oct05
|
Oct05
|
| | |
Oct05
|
Oct05
|
Oct05
|
|
Sleepers Arrive |
Oct05
|
Oct05
|
|
|

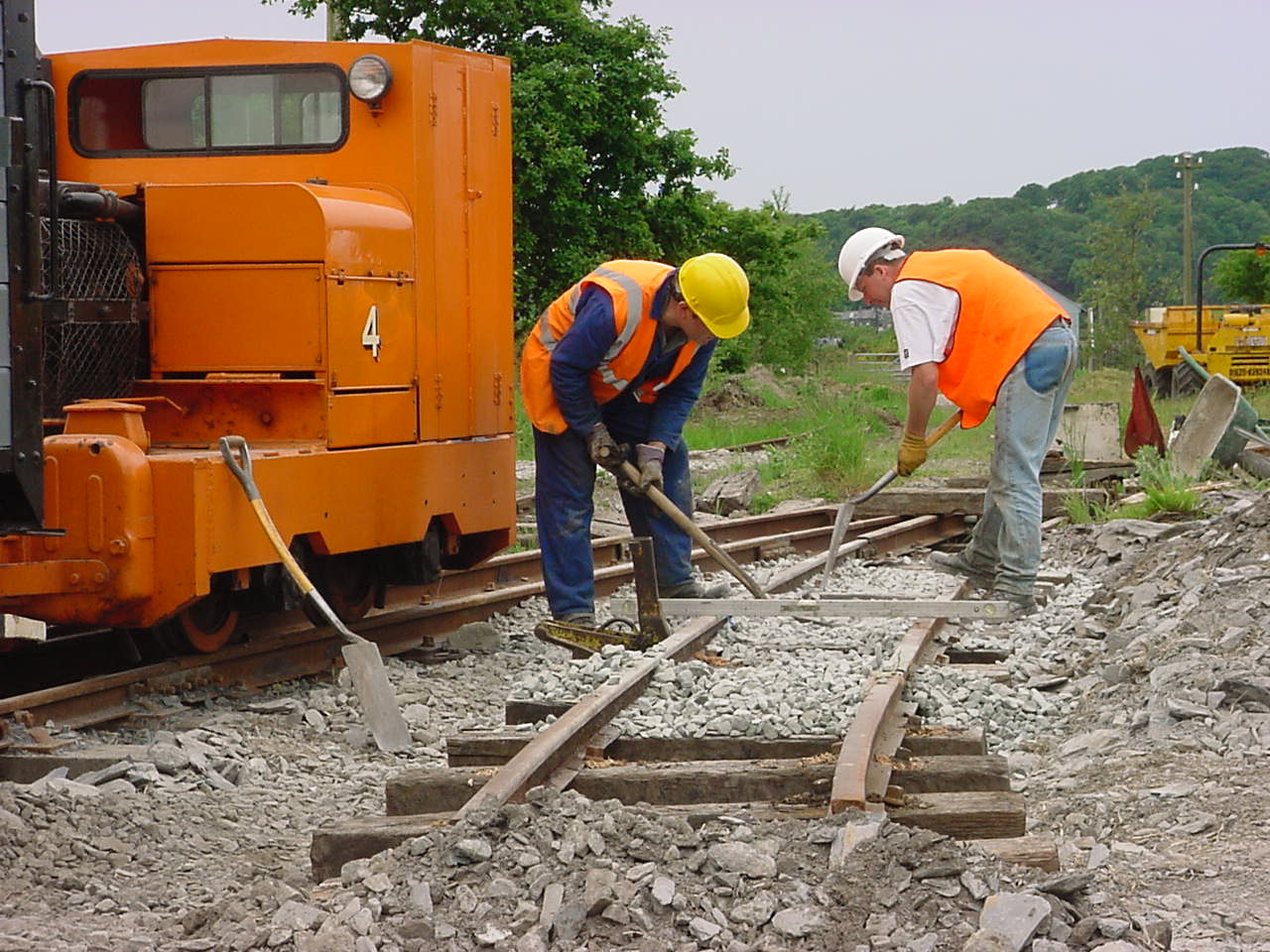

Tracklaying |
Mar06
|
|
Harbour Siding, most of the rails have now been unloaded, and either laid, or
moved further north |
Apr06
|
|
Extension Train waits for clearance to continue its way back to Gelerts Farm. |
Jul06
|
|
Chanoler runs round, whilst Lyd2-60 Eryri waits to haul a balast train. |
Aug06
|
|
The start of a new section |
Mar
07
|
